BESS for EV Charging Stations

BESS for EV Charging Stations

EV Charging Energy Storage

When charger demand is higher than the grid can comfortably supply

Battery energy storage can provide additional power during EV charging peaks, allowing commercial charging sites, fleet depots and fast-charging hubs to manage grid import more actively.

The key question is not simply “How many kWh of battery do I need?” It is how much charging power must be supported, for how long, and how much power the existing grid connection can provide.

EV charging station BESS solution integrating solar PV utility grid battery storage and DC fast chargers
Grid + solar PV + BESS + DC fast-charging architecture.
Start With the Power Gap

EV charging BESS sizing starts with charger concurrency and grid capacity

A charging station may have a high installed charger rating while only part of that capacity operates simultaneously. The BESS should therefore be engineered from the expected coincident charging demand rather than simply adding together every charger's nameplate power.

Step 01 Charger Demand Charger quantity × actual concurrent charging behavior.
Step 02 Grid Limit Transformer capacity and permitted site import define available grid power.
Step 03 BESS Support Battery and PCS supply the temporary difference when charging demand rises.
Preliminary Engineering Logic
Required BESS Power ≈ Coincident Site Demand − Permitted Grid Import
Usable Battery Energy ≈ BESS Support Power × Required Support Duration

Final sizing must additionally consider charging efficiency, battery DoD, SOC reserve, auxiliary loads, degradation, solar generation and required charging cycles per day.

Charging-Site Profiles

Not every EV charging site needs the same BESS

The charging pattern determines whether the project is mainly a high-power problem, an energy-duration problem or an energy-scheduling problem.

Public / Highway Fast Charging

Short, high-power charging peaks

Several DC fast chargers can start within a short period, creating a rapid increase in grid demand.

Design priority:
PCS power · grid limit · charger concurrency · short-duration support
Fleet / Logistics Depot

Predictable charging windows

Commercial fleets often return within defined periods, allowing EMS scheduling around departure times, available grid power and required daily energy.

Design priority:
Daily kWh · charging window · SOC target · EMS scheduling
Retail / Commercial Charging

Charging + building load + solar PV

The charging load must share electrical capacity with the building, while rooftop or carport PV can provide another energy source.

Design priority:
Building load · PV profile · charger demand · peak-demand control
Charging Peak Management

BESS acts as a power buffer between the grid and charger demand

During lower-demand periods, the battery can recharge from the utility grid or available solar PV.

When several chargers operate simultaneously and site demand rises above the configured grid-import target, the BESS can discharge through the PCS to supply part of the charging load.

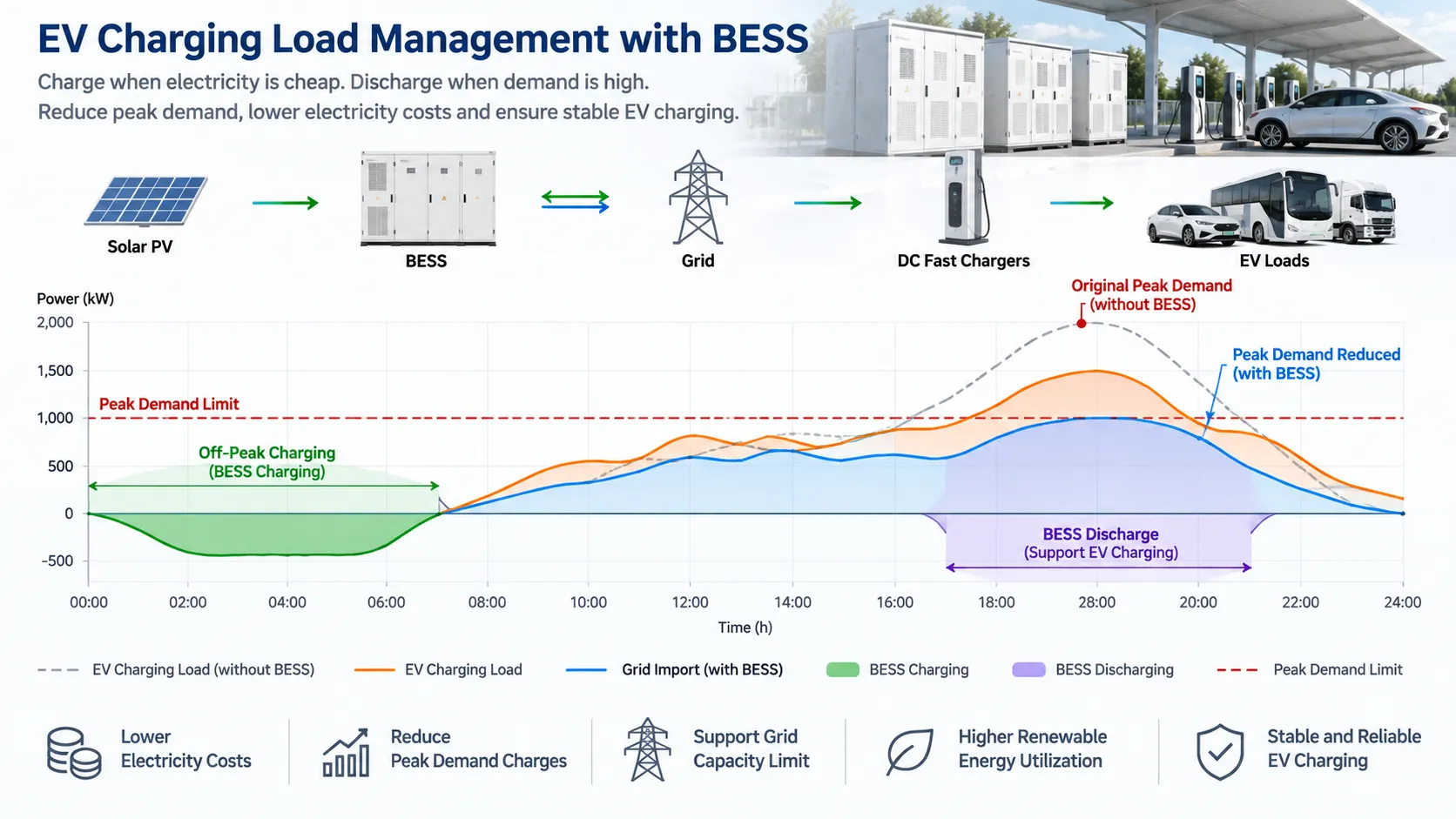

EV charging BESS load curve showing charger demand battery charging discharge and reduced utility grid import
Example charging profile with BESS discharge during charger-demand peaks.

What changes when battery storage is added to the charging site?

Engineering Issue Grid-Only Charging Site Grid + BESS
Charging Peak Grid supplies the full coincident charging load. Battery can supply part of the temporary peak.
Transformer Capacity Charger growth may increase required grid infrastructure. BESS can support selected peaks within the engineered system limits.
Solar PV PV must be consumed, exported or curtailed when generated. Available PV energy can be stored for later vehicle charging.
Charger Expansion Expansion depends strongly on available utility capacity. BESS provides another controllable source of charging power.
Site Control Charger demand largely follows vehicle behavior. EMS coordinates charger demand, grid import, PV and battery SOC.
Electrical Architecture

EV charging BESS has two architectures: power flow and control

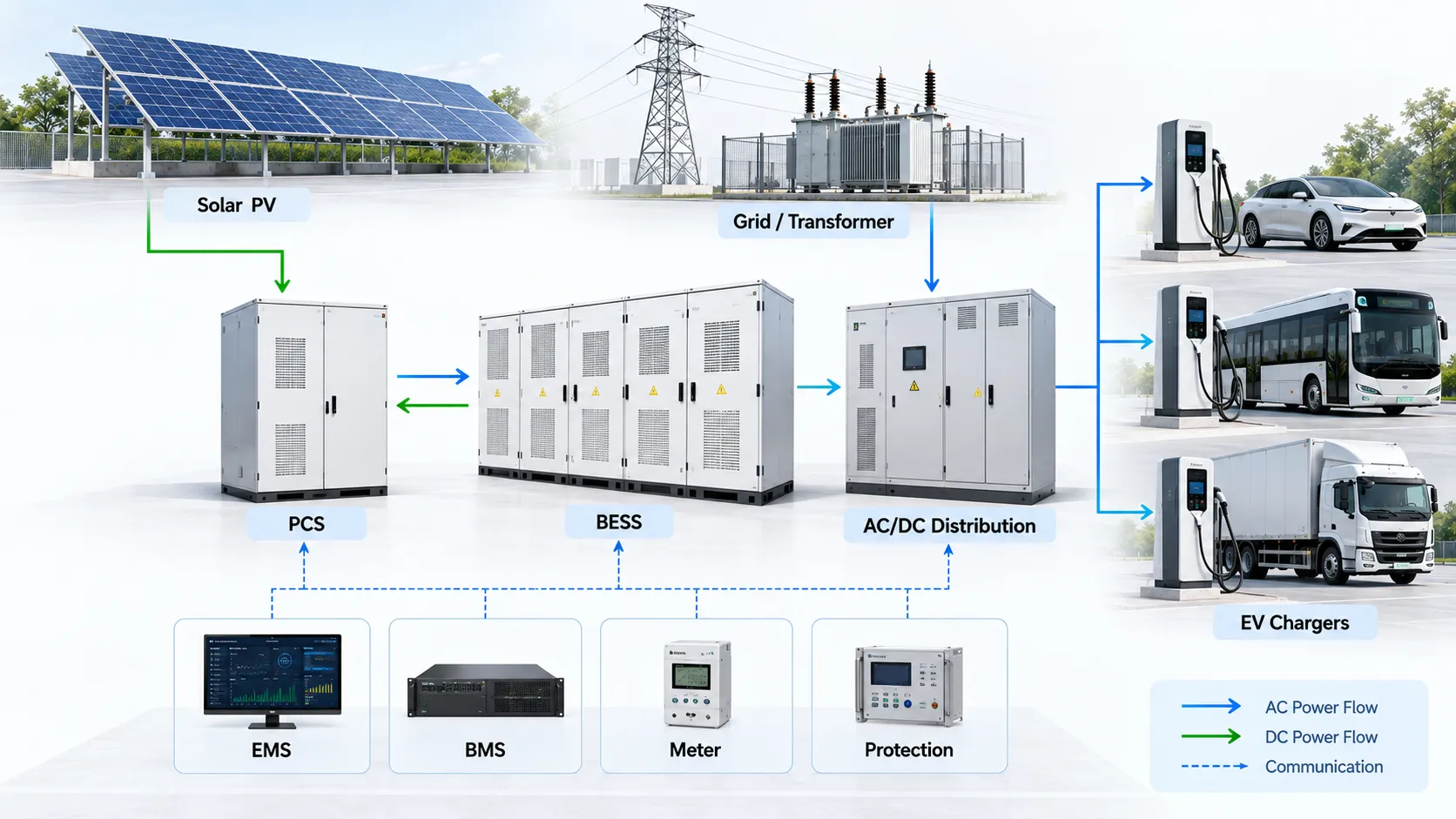

EV charging BESS architecture with solar PV grid transformer PCS battery storage EMS BMS metering and DC fast chargers
Typical power and control architecture for a grid-connected EV charging + BESS site.
Power Layer
Grid / Transformer
↓
AC Distribution / PCS
↕
BESS
↓
EV Chargers
Control Layer

Site Meter measures grid import.
EMS decides when charging or discharging is required.
BMS reports SOC, alarms and allowable battery limits.
PCS executes the required power command.
Charger Management may coordinate EV charging priorities where supported.

Before Selecting the Battery

Five questions determine the EV charging BESS

1. How many chargers? Charger quantity and individual rated power.
2. How many charge at once? Expected concurrency is usually more useful than installed charger capacity alone.
3. How much grid power is available? Confirm transformer rating and permitted utility import.
4. How long does the peak last? Peak duration drives the usable battery-energy requirement.
5. What is the daily charging pattern? Sessions, energy throughput and recharge windows determine SOC strategy.
EV charging hub with DC fast chargers battery energy storage transformer switchgear and solar canopy
Where BESS Fits

Charging infrastructure extends far beyond public charging stations

BESS can be evaluated anywhere the EV charging requirement creates a meaningful difference between charger demand and available electrical capacity.

DC Fast-Charging Hubs
Fleet Depots
Logistics Centers
Bus Charging
Retail Parking
Industrial Charging
Highway Sites
Solar Charging Hubs
BESS Platform Matching

Match the storage platform to charger power and support duration

The examples below are product platforms rather than automatic sizing recommendations. Final selection requires charger-demand and site-power data.

Platform Why Consider It Typical EV Charging Direction Product
125kW / 232.9kWh 125kW power class with medium-duration energy storage. Commercial charging, peak support and PV-connected charging. View →
125kW / 261.2kWh Higher battery-energy reserve with 125kW rated output. Fleet sites, charging hubs and multi-mode C&I applications. View →
1MWh–5MWh Containerized BESS Project-scale energy storage with PCS configuration engineered to the site. Large charging hubs, fleet campuses and charging microgrids. View →
Charging-Site Expansion

Design the BESS around how the charging site will grow

Phase 1, Existing Grid Capacity

Establish the transformer limit, base building load and permitted charging power.

Phase 2, Add BESS Power Support

Use battery storage to support selected charging peaks and manage grid import.

Phase 3, Solar / More Chargers / Multi-Cabinet Expansion

Expand energy capacity, charging infrastructure and renewable generation according to future site demand and electrical architecture.

Need to size the charging-site BESS? Continue with the sizing guide for kW / kWh logic, or review datasheets and system documentation.

Where EV charging overlaps with other BESS applications

If the main problem is the site power peak: C&I BESS for Peak Shaving →
If the charging site includes solar canopies or rooftop PV: Solar + BESS for C&I →
If charging is part of a factory or logistics campus: BESS for Factories & Industrial Parks →
If the site combines solar, generator and islanding functions: Microgrid Battery Energy Storage →
EV Charging BESS FAQ

Engineering questions about EV charging battery storage

Should BESS size be based on total installed charger power?

Not necessarily. Expected charger concurrency, vehicle behavior, existing site loads and the available grid connection should also be considered when determining required battery and PCS power.

Can BESS support DC fast chargers?

Yes, when battery power, PCS capability and the electrical architecture are sized for the required support power and duration.

Can solar PV and EV charging use the same BESS?

They can be integrated within the same site energy strategy when the inverter or PCS architecture, EMS logic and electrical interfaces are designed accordingly.

Can BESS eliminate the need for a transformer or grid upgrade?

Not in every project. BESS can support short-duration charging demand and reduce grid import, but utility requirements, protection studies, future expansion and site design determine whether infrastructure upgrades remain necessary.

What data should be provided for an EV charging BESS proposal?

Provide charger quantity, charger ratings, expected concurrency, existing building load, transformer or grid limit, charging-session profile, required charging hours, PV information, site voltage and planned future charger expansion.

EV Charging Site Engineering

Send us the charger list, not only the required battery capacity

Share the number of chargers, charger power, expected concurrency, transformer or grid capacity, existing site load, charging schedule, solar PV information and future expansion plan. We can then review the required BESS power, usable energy and system architecture.
