C&I BESS Sizing Guide

Commercial & Industrial Battery Energy Storage Sizing

Size a commercial and industrial BESS by separating power in kW from energy in kWh, then matching PCS capability, battery capacity, operating duration and electrical integration to the actual site requirement.

The correct system size depends on the load profile and operating objective — not on battery capacity alone. Peak shaving, solar storage, backup power, EV charging and microgrid applications can require very different power-to-energy ratios.

C and I BESS sizing guide showing load profile kW power kWh energy PCS sizing and battery storage applications
C&I BESS sizing starts with the site load profile, required power, required energy, PCS capability and the final operating objective.
kW vs kWh PCS Sizing Battery Capacity DoD & Efficiency C-Rate Runtime

Start with kW and kWh

The first step in BESS sizing is to separate power from energy. A battery may contain enough energy but still be unable to deliver the required instantaneous power. Likewise, a PCS may have enough output power while the battery does not contain enough usable energy to sustain that output for the required duration.

Power

kW = How Much Power?

kW defines how much active power the BESS must deliver or absorb at a given moment. It is a major driver of PCS power rating and battery discharge capability.

Energy

kWh = For How Long?

kWh defines the stored energy available to support the required power over time. It is primarily driven by the required load and operating duration.

kW versus kWh in C and I BESS sizing showing PCS power battery energy capacity and runtime
kW defines the required power capability, while kWh determines how long that power can be sustained.

Basic C&I BESS Sizing Formulas

The following equations are useful for preliminary system sizing. Detailed engineering should also account for manufacturer operating limits, system topology, environmental conditions and project requirements.

1. Required Peak-Shaving Power

BESS Power = Site Peak − Target Grid Limit

For peak shaving, this difference provides the preliminary AC power that the BESS may need to supply during the peak period.

2. Required Delivered Energy

Energy (kWh) = Power (kW) × Duration (h)

This calculates the basic energy that must be delivered during the required operating period.

3. Preliminary Nominal Battery Energy

Nominal kWh ≈ Required Energy ÷ (Usable DoD × Discharge-Path Efficiency)

Additional allowance may then be required for reserve SOC, auxiliary consumption, temperature effects, degradation and end-of-life capacity requirements.

Data Needed Before Sizing a C&I BESS

Reliable BESS sizing should start with actual electrical and operating data. Selecting a battery capacity before understanding the site load profile can lead to an undersized or unnecessarily oversized system.

Load Profile
Preferably 15-minute or higher-resolution demand data.
Peak Demand
Maximum kW and duration of recurring demand peaks.
Target Grid Limit
Maximum desired utility-grid import after BESS support.
Site Voltage & Frequency
Required for PCS, transformer and switchgear integration.
Transformer Capacity
Existing transformer and grid-connection operating limits.
Solar PV Profile
Installed or planned PV capacity and time-based production data.
Tariff Structure
Time-of-use pricing, demand charges and relevant peak periods.
Backup Requirement
Critical-load power, starting requirements and required runtime.
Operating Strategy
Peak shaving, load shifting, solar storage, backup, EV charging or microgrid.
Site Conditions
Ambient temperature, altitude, installation space and environmental requirements.

Step-by-Step C&I BESS Sizing Process

01

Define the Application

Determine whether the primary objective is peak shaving, solar energy shifting, backup power, EV charging, tariff optimization or microgrid operation.

02

Analyze the Load Profile

Identify maximum demand, peak duration, daily operating pattern, seasonal variation and recurring high-load periods.

03

Calculate Required kW

Determine the maximum charge and discharge power the PCS and battery system must support.

04

Calculate Required kWh

Multiply required power by duration, then account for usable DoD, conversion losses, reserve energy and operating limits.

05

Verify Battery & PCS Limits

Check C-rate, battery current, DC voltage window, PCS power, overload capability and charge/discharge restrictions.

06

Verify Site Integration

Check voltage, transformer, switchgear, protection, metering, EMS communications and grid-connection requirements.

07

Add Engineering Margin

Consider reserve SOC, battery degradation, end-of-life capacity, ambient conditions, cycle profile and expected future load growth.

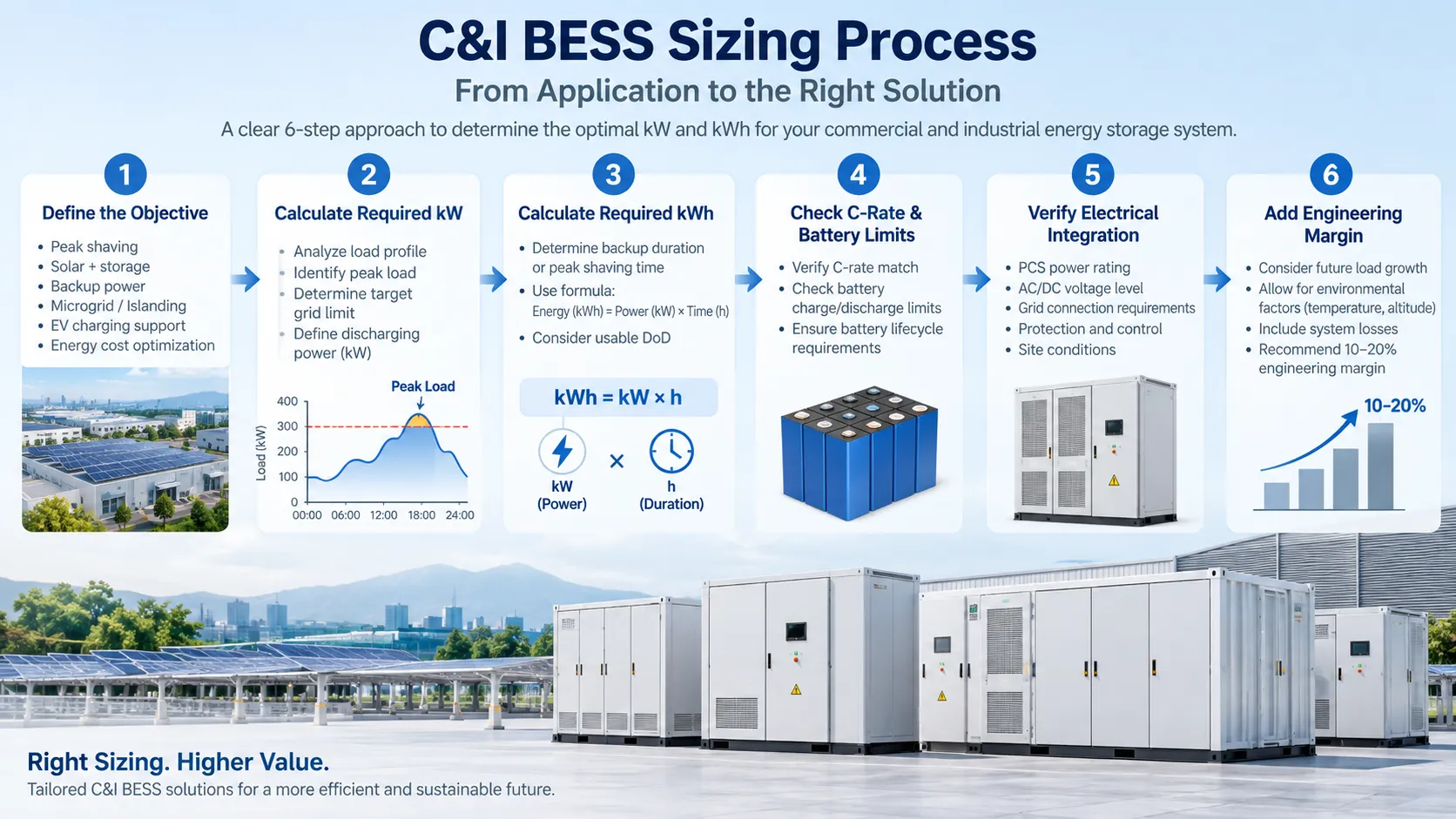

C and I BESS sizing process from load profile and required kW to kWh C rate PCS electrical integration and engineering margin
A practical C&I BESS sizing workflow from load analysis to kW, kWh, battery limits, electrical integration and engineering margin.
Worked Example

Example: 80kW Peak Reduction for 2 Hours

Assume a factory needs to reduce grid demand by approximately 80kW during a production peak that lasts about 2 hours.

Required AC Support
80kW
Required Duration
2 Hours
Basic Delivered Energy
160kWh
Basic calculation
80kW × 2h = 160kWh

The 160kWh value represents the basic energy required for the load-support period. It should not automatically be treated as the final installed battery capacity.

The final nominal battery capacity should also account for usable depth of discharge, PCS and discharge-path losses, reserve SOC, auxiliary consumption, temperature, degradation and required end-of-life performance.

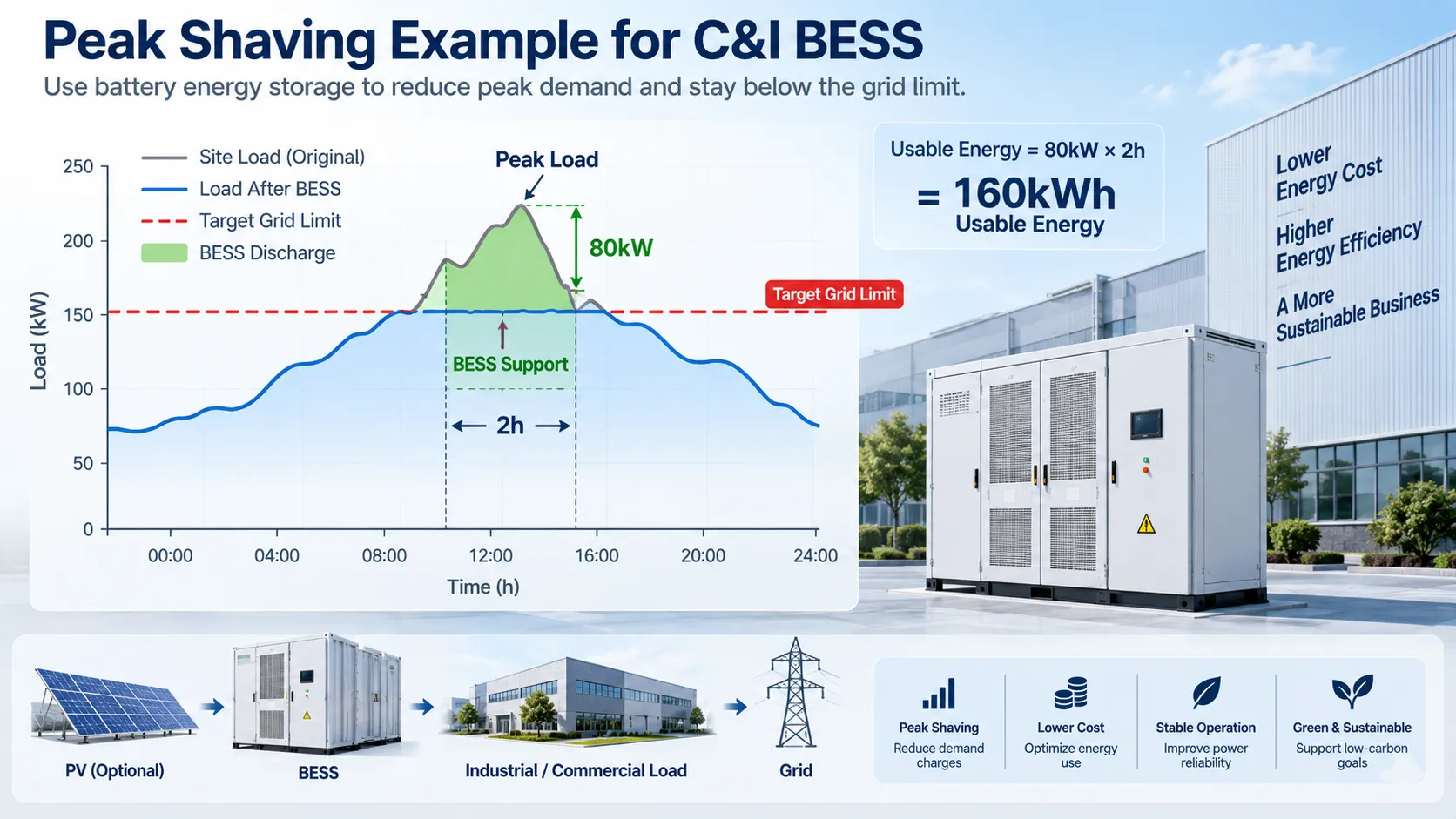

C and I BESS sizing example with 80kW peak reduction for two hours and 160kWh required delivered energy
Example sizing logic: 80kW of required support for two hours corresponds to 160kWh of basic delivered energy before engineering allowances.

How BESS Sizing Changes by Application

The same battery capacity can behave very differently depending on how the system is used. The primary kW and kWh drivers should therefore be defined before selecting equipment.

Application Primary kW Driver Primary kWh Driver
Peak Shaving Difference between site peak demand and target grid limit Duration and frequency of the demand peak
Solar + Storage Required charging and discharging power Surplus PV energy available for time shifting
Backup Power Maximum critical-load power and transient requirements Required backup runtime and reserve SOC
EV Charging Charger concurrency, grid limit and charging peak Duration and frequency of the charging shortfall
Microgrid Critical or total site load and PCS operating strategy Required islanded operating duration and generation profile

Do Not Ignore C-Rate

C-rate describes the relationship between battery power and battery energy. As a simplified example, a 200kWh battery delivering approximately 100kW at battery level is operating near 0.5C.

Approximate C-Rate = Battery-Side Power (kW) ÷ Nominal Battery Energy (kWh)

When only AC-side PCS power is known, conversion efficiency should be considered before using the value as battery-side DC power.

The selected cell, module, battery rack, BMS, busbar and thermal-management system must all support the required charge and discharge current within their specified limits.

Engineering Checks Beyond kWh

Battery energy is only one part of system sizing. Before selecting a final C&I BESS configuration, the complete AC and DC architecture should also be reviewed.

Engineering Check What to Verify
PCS Power Required charge/discharge kW, overload capability and operating mode.
kW vs kVA Check active power, apparent power and required power-factor operating range.
Battery DC Voltage Confirm the battery voltage window is compatible with the PCS DC input range.
Transformer Check site voltage, transformer loading, connection point and required step-up or isolation architecture.
Switchgear & Protection Review breakers, protection coordination, isolation and connection requirements.
EMS & Metering Confirm meter location, control logic, BMS/PCS communication and required protocols.
Backup Architecture If backup is required, confirm PCS capability, switching architecture, critical-load separation and transfer requirements.
Thermal & Environmental Check ambient temperature, altitude, cooling, enclosure rating, clearances and site conditions.
Example System Platforms

C&I BESS Platforms for Engineering Review

Preliminary sizing should first establish the required power and energy. A specific BESS platform can then be evaluated against voltage, PCS capability, battery operating limits, thermal design and site integration requirements.

LIQUID-COOLED C&I ESS

125kW / 232.9kWh Liquid-Cooled C&I ESS

A 125kW commercial and industrial platform for projects requiring approximately 233kWh of rated battery energy.

View System Specifications →
LIQUID-COOLED C&I BESS

125kW / 261.2kWh Liquid-Cooled C&I BESS

A higher-energy 125kW platform for C&I energy-management and scalable multi-cabinet projects.

View System Specifications →

Common C&I BESS Sizing Mistakes

Sizing only by kWh
Battery energy alone does not confirm that enough discharge power is available.
Using only one peak value
A monthly maximum demand value does not show the duration or shape of the peak.
Ignoring DoD and reserve SOC
Not all nominal battery energy should automatically be assumed usable.
Ignoring C-rate
The battery must be capable of safely supplying the required power.
Confusing kW and kVA
PCS apparent-power rating should be evaluated together with active power and power factor.
Ignoring degradation
Required end-of-life performance should be considered during initial sizing.
Ignoring site electrical limits
Transformer, voltage, switchgear and grid requirements can constrain the final system design.
Assuming every BESS provides UPS-like backup
Backup capability depends on PCS, switching, protection and overall system architecture.
Engineering Resources

C&I BESS Technical Downloads

After preliminary sizing, review the applicable BESS datasheets, system architecture, single-line diagrams, installation documents and EMS/BMS/PCS integration information before final equipment selection.

View C&I BESS Technical Downloads →
Datasheets · System Architecture · SLDs · Installation Documents · EMS / BMS / PCS Integration Resources

Questions About C&I BESS Sizing

How do I calculate the required BESS size in kWh?

Start with the required power in kW multiplied by the required operating duration in hours. Then account for usable depth of discharge, discharge-path efficiency, reserve SOC, degradation and other project-specific margins when determining nominal battery capacity.

What is the difference between kW and kWh in BESS sizing?

kW represents the power the system must supply or absorb at a particular moment, while kWh represents the amount of energy available to sustain that power over time.

How much BESS is required for peak shaving?

Determine the difference between the site's peak demand and the desired grid-import limit, then determine how long that reduction must be maintained. Both the required PCS power and battery energy should be checked against the actual load curve.

Why is C-rate important when sizing a BESS?

A battery can contain sufficient energy but still be unable to deliver the required power if the required charge or discharge rate exceeds the limits of the cells, modules, BMS or thermal-management system.

How do I size a BESS for backup power?

Determine the maximum critical-load power and required backup duration, then account for usable DoD, conversion efficiency, reserve SOC and operating limits. The electrical architecture must also support the required backup and transfer mode.

Should battery degradation be included in BESS sizing?

Yes. Expected capacity loss, cycle profile, operating temperature and the required end-of-life usable capacity should be considered during detailed system engineering.

C&I BESS Engineering Support

Need Help Sizing a C&I BESS?

Send us your load profile, peak demand, target grid limit, grid voltage, transformer data, solar PV capacity, tariff information and backup requirements. We can evaluate the appropriate BESS power, energy and system configuration for your project.

Request a BESS Sizing Review
